▶ Case Study — YouTube Build Review

Budget DIY Container Shop for Under $15,000

Structure2 × 40-ft containers + spanning roof
Total costUnder $15,000
Covered area~1,440 sq ft
Cost per sq ft~$10
PublishedFebruary 11, 2024
Ambition Strikes — “Building a Budget DIY Container Shop — Full Build” Published February 11, 2024
Watch on YouTube: youtu.be/xwgX888Kn1Q ↗
Source video

01 — Overview1,440 Square Feet for Under $15,000

Ambition Strikes’ container shop build is one of the most cost-efficient large-footprint workshop structures documented on YouTube. Two 40-ft shipping containers placed parallel with a gabled roof spanning the gap: under $15,000 for 1,440 square feet of covered workspace — roughly $10 per square foot.

The build achieves this through three specific salvage strategies applied in combination: used containers, salvaged trusses, and self-milled lumber. Any one of these alone reduces cost significantly; all three together produce a result conventional building approaches cannot match.

02 — ConfigurationThe Parallel Two-Container Layout

Two 40-foot containers placed parallel with a 16–20ft gap, spanned by a gabled roof. This creates three distinct functional zones:

ZoneDimensionsBest Uses
Container 140ft × 8ft = 320 sq ftEnclosed, lockable tool and equipment storage
Center span40ft × 20ft = 800 sq ftVehicle work, fabrication, welding — open sides for ventilation
Container 240ft × 8ft = 320 sq ftSecond storage bay, dedicated workbenches
TOTAL~1,440 sq ft covered$10/sq ft all-in

The open center span provides headroom and unobstructed floor space for vehicle work — neither container alone has adequate width. Natural ventilation through the open sides is critical for welding fumes and exhaust.

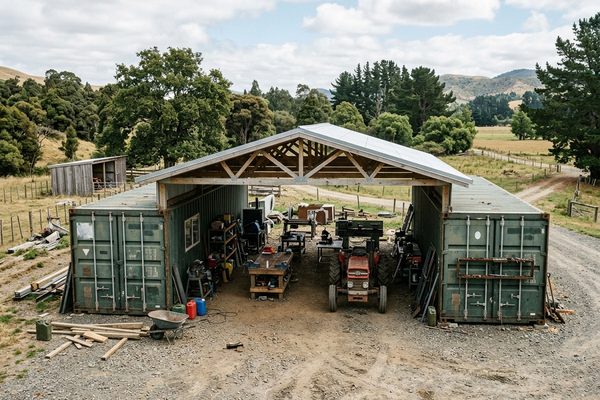

Two parallel shipping containers with gabled roof forming a working workshop with tractor and equipment
The parallel two-container configuration in practice — two enclosed storage bays and an open center span large enough for a tractor, all under one gabled roof

03 — Cost StrategiesThree Moves That Reach $15,000

Strategy 1: Used containers ($4,000–$9,000 delivered)

Used 40-ft containers in wind-and-watertight (WWT) condition are adequate for workshop use. Surface rust and cosmetic wear are acceptable; structural integrity at corner posts and rails is the only requirement. For a non-residential workshop, WWT grade avoids the premium cost of cargo-worthy or one-trip units.

📦

Shop Used 40-ft Containers on eBay

Browse the largest eBay collection of used and WWT 40-ft shipping containers with delivery to your location.

Browse 40-ft Containers on eBay →

Strategy 2: Salvaged trusses ($200–$1,000 vs. $2,000–$8,000 new)

New prefab trusses at retail: $60–$500 each. Used trusses from demolitions or salvage yards: $5–$50 each. For a 40-foot building requiring ~21 trusses, this single sourcing decision saves $2,000–$7,000. Critical requirement: every used truss must be inspected for damaged chord members, broken web connections, water damage to connector plates, and compromised structural connections before use. A failed truss in a loaded roof is dangerous.

Strategy 3: Self-milled lumber ($0–$500 vs. $3,000–$8,000 retail)

Retail dimensional lumber for a full roof framing package: $3,000–$8,000. A chainsaw mill attachment ($150–$400) converts standing timber into dimensional lumber at the cost of time and fuel. Key requirement: green lumber must be air-dried for months before structural use. Plan the milling several months before the build begins.

04 — CostsFull Budget Breakdown

CategoryAmbition Strikes Est.Retail Alternative
Two 40-ft containers (used, WWT)$4,000–$8,000$8,000–$12,000 (one-trip)
Foundation (compacted gravel)$300–$800$2,000–$8,000 (concrete)
Used trusses (matched set)$200–$1,000$2,000–$8,000 (new)
Self-milled lumber (purlins, fascia)$0–$500$2,000–$5,000 (retail)
Metal roofing panels$1,000–$2,500$1,500–$3,500
Fasteners, hardware, flashing, gutters$400–$900$600–$1,200
Electrical (panel, wiring, lighting)$600–$2,000$600–$2,000
TOTAL~$7,900–$15,700$17,000–$40,000

05 — ComparisonContainer Shop vs. Alternatives

StructureCost (similar size)DurabilityBuilt-in Secure Storage
Container shop (this build)~$15,000Excellent — 25–50+ yearsYes — inherent
Steel building kit (40×40)$18,000–$35,000ExcellentNo — requires extra cost
Pole barn (40×40)$15,000–$35,000Good — 20–40 yearsNo — requires extra cost
Conventional framed shop$40,000–$80,000GoodStandard
ContainerTrends summary

Key lessons from the Ambition Strikes container shop

  • Two containers plus a spanning roof is the most cost-efficient large workshop footprint available to the DIY builder. At ~$10/sq ft all-in, the parallel container shop undercuts every alternative while providing more inherent security through the container shells.
  • Used trusses are the highest-leverage salvage purchase in this build. The difference between new and salvaged trusses is $2,000–$7,000. Inspection is mandatory — a structurally compromised truss in a loaded roof is dangerous.
  • Self-milling lumber is the most time-intensive cost reduction and requires advance planning. Green lumber must be milled months before it is needed to allow adequate drying time.
  • Truss permanent bracing is as important as truss installation. A set of correctly installed but unbraced trusses can rack and collapse in wind loading. Install diagonal bracing as trusses go up, not as an afterthought.
  • The parallel container shop scales gracefully. Start with two containers. Add more, extend the span, enclose the ends, add insulation and climate control — each step is independent and budget-manageable.
  • Container shops blur the line between workshop and homestead infrastructure — covered vehicle storage, secure tool building, fabrication workspace, and a foundation for future expansion for the cost of a used pickup truck.
